Skip to main content

OS Update Policies

  • May 14, 2026
  • 8 replies
  • 34 views

Forum|alt.badge.img+8
  • Valued Contributor

I’m curious to know how other organizations are handling OS updates. Not so much in terms of applying them but more so in terms of testing. How long do you typically defer updates in your environment? What is your testing methodology and criteria for deployment?

8 replies

Chubs
Forum|alt.badge.img+26
  • Jamf Heroes
  • May 14, 2026

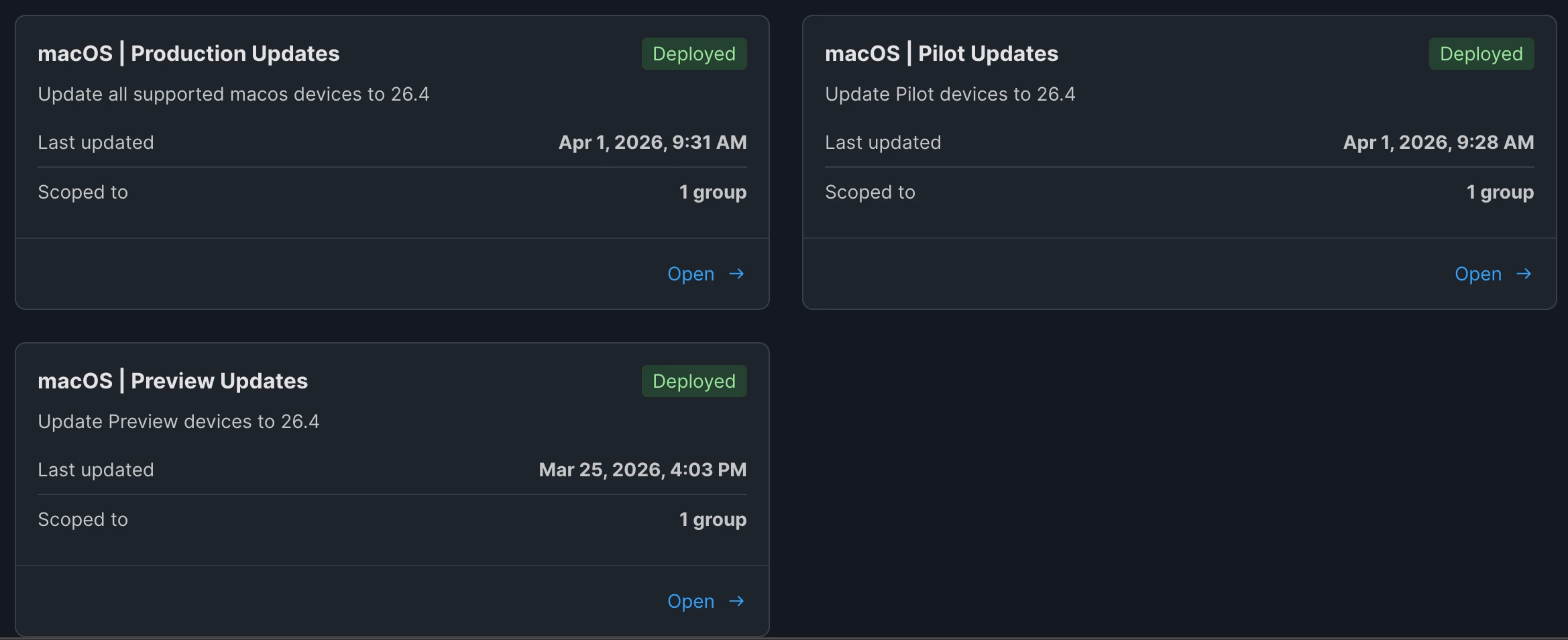

We mirrored our Intune rings in Jamf.

Preview = day 0
Pilot = day 7
Production = day 30.

All of these using blueprints to apply.


Chris_Hafner
Forum|alt.badge.img+27

We’re pretty similar to what ​@Chubs posted. A little faster on the pilot (3 days) and Production (14 days) but our testing is pretty quick/routine. There’s not a lot of gotchas for us as we’re able to keep relatively well ahead on software roadmaps.



With that said, we’re still more likely to find a major issue reading various tech blogs or Jamf Nation!


dletkeman
Forum|alt.badge.img+17
  • Jamf Heroes
  • May 14, 2026

For major updates (18 => 26) I usually wait for the x.1 release + 1 week.

For minor updates I usually wait for release + 1 week.

This has got us in trouble once but I don’t think it would have been much different even if we had waited 30 days as it was an issue with a specific type of app but wasn’t fixed until the next minor release.

I tried blueprints but had a lot of negative feedback especially for devices that were low on storage so I just push out over the weekend manually.

I sometimes adjust based on holidays or strategize around big projects.


Chubs
Forum|alt.badge.img+26
  • Jamf Heroes
  • May 14, 2026

For major updates (18 => 26) I usually wait for the x.1 release + 1 week.

For minor updates I usually wait for release + 1 week.

This has got us in trouble once but I don’t think it would have been much different even if we had waited 30 days as it was an issue with a specific type of app but wasn’t fixed until the next minor release.

I tried blueprints but had a lot of negative feedback especially for devices that were low on storage so I just push out over the weekend manually.

I sometimes adjust based on holidays or strategize around big projects.

For majors that’s what we do too.  We wait for the enterprise release (X.1) and then a 30 day window...then deploy.


TebowTIME
Forum|alt.badge.img+1
  • New Contributor
  • May 14, 2026

Also Curious if people have multiple blueprints for different “waves”, we are using two, one for testing and one for production.


Chubs
Forum|alt.badge.img+26
  • Jamf Heroes
  • May 14, 2026

Also Curious if people have multiple blueprints for different “waves”, we are using two, one for testing and one for production.




Forum|alt.badge.img+8
  • Author
  • Valued Contributor
  • May 15, 2026

Can I ask what your validation processes look like?


Forum|alt.badge.img+8
  • Author
  • Valued Contributor
  • May 15, 2026

Also Curious if people have multiple blueprints for different “waves”, we are using two, one for testing and one for production.



I’ve moved our mobile devices over to blueprints but haven’t done so with the Macs. My current setup looks something like yours but I have labs and kiosk devices broken into different blueprints. I envy the elegance of yours.
